Streets, roads and pavements

York outer ring road dualling scheme

YORR dualling scheme

We’re asking for you to comment on the proposals to improve the York Outer Ring Road, A1237, (YORR).

The scheme concerns the section of the A1237 from A19 Shipton Road to A1036 Little Hopgrove, and involves the upgrade of 6 sections of the northern YORR, including 5 roundabouts at:

  • Clifton Moor
  • Wigginton Road
  • Haxby Road
  • Strensall Road
  • Monks Cross

The performance of the YORR will be improved by widening the existing single-carriageway road to dual-carriageway roads in both directions.

Roundabouts will be enlarged with additional approach lanes, increasing the capacity for traffic to flow between and through the roundabouts.

These 5 roundabouts will be enlarged to a similar size and standard as was recently undertaken at the A1237/B1224 Wetherby Road roundabout, completed in 2019.

You can either visit our online virtual exhibition and navigate around the exhibition room by clicking on the arrows on the floor to move around or download further information.

We'll update this page as the YORR project progresses:


The need for YORR improvements

The upgrade of the road and the roundabouts will help to reduce congestion and journey times, encouraging traffic out of the city centre in line with our carbon reduction and air quality ambitions, and onto larger roads where flows can be managed effectively.

We will not be introducing any 'grade-separation' at junctions, using flyovers and underpasses, as this would be significantly more expensive than current proposals, and would not be cost-effective due to the prohibitively high cost of the structures involved and extra land required, for example for slip road construction.

We will however be constructing new pedestrian and cycle subways underneath the A1237 as part of these works.

This will be supported by other council projects to improve public transport, cycling and walking in the city centre, in order to ‘lock in’ the benefits that the YORR improvements will deliver.

The funding commitment of £38 million by the West Yorkshire Combined Authority, £25 million from the Department for Transport, along with additional contributions of £8.6 million (which includes the council’s own contribution of £3.6 million) has enabled us to progress this scheme.

Surveys of traffic flows at roundabouts on the A1237 which have already been upgraded in recent years have shown that journey times have reduced by up to 4 minutes even with a 30% increase in the number of vehicles passing through the junction (evidence from the A59/A1237 roundabout, upgraded in 2014).

York’s draft Local Plan shows where development is anticipated to take place over the next 15 years, including areas set aside for housing and new jobs. Reducing existing journey delays and improving active travel options will help us to manage the extra traffic as more people commute to work and travel to access education, services and other facilities.

Top of page


Prioritisation of the northern YORR

The northern sections of the A1237 have been prioritised as the most beneficial to be upgraded at this time, with the largest impact on reducing congestion and delays.

We don't have the level of funding to progress upgrading further stretches of the A1237 to the west of the city, especially the busy sections which cross the River Ouse and the East Coast railway line. This is due to the prohibitive expense of the new structures, such as bridges, required here.

However we continue to pursue further funding opportunities to help realise the aspiration of full dualling of all of the A1237 in the future.

Dualling of the A64 east of Hopgrove

The A64 is a strategic road (trunk road) and is operated and maintained by Highways England, not the council. Proposals for the A64 east of Hopgrove were put forward for funding via the government’s Road Investment Strategy 3 (RIS3).

Top of page


Construction stages and duration

Subject to planning consent, construction work on the YORR is anticipated to commence in mid-2023 for 2 years, with completion in 2025.

The scheme involves the construction of a bridge over the York to Scarborough railway line, and another over the River Foss.

The majority of the widening will be constructed to the north of the existing A1237 Ring Road and will be off-highway, which will allow the existing 2-way traffic flow to be maintained for the majority of the construction stage, minimising any disruption to the travelling public.

Further updates relating to construction activities will be provided as the scheme develops.

Order of construction work

The order in which construction will take place will depend upon how the contractor who wins the tender for construction chooses to carry out the works. Much of the widening works will be carried out “offline” without affecting the flow of the existing A1237.

Overnight works

The majority of the construction work will be carried out during daylight hours, although there will be some work done at night. We'll keep noise and disruption to any nearby properties as low as possible. Access for emergency services will be maintained at all times.

Top of page


Improvements for pedestrians and cyclists

As an important part of the scheme we're looking to upgrade pedestrian and cycle facilities, creating an orbital cycle and pedestrian route to help encourage the uptake of active travel. The scheme proposes:

  • significant additional pedestrian and cycleway networks, creating safe and attractive routes helping to link residential areas with key employment, retail and educational facilities
  • retaining and enhancing all public footpaths and bridleways, with some new connections and safer crossing facilities
  • a new underpass at Clifton Moor
  • 2 new underpasses at Haxby, in addition to the 2 that exist at present
  • a new underpass at Strensall Road roundabout

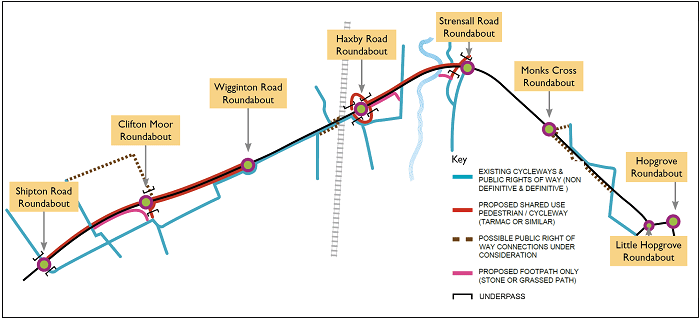

York outer ring road roundabouts location diagram

Top of page


Landscaping and biodiversity

The project includes a comprehensive landscape scheme, retaining existing trees and hedgerows where we can, and employing a policy of ‘net gain’ to provide substantial additional tree planting and landscaping along the route. We're aiming to introduce:

  • tree and woodland planting
  • species-rich hedgerow planting
  • specimen trees and feature planting at key locations
  • species-rich grassland including wildflowers
  • a system of sustainable drainage ditches

The landscaping scheme will incorporate a range of biodiversity measures including planting to benefit pollinators. It will complement the local environment, integrating the new road corridor into the fabric of the existing landscape.

We're also committed to the efficient use of natural resources for carbon absorption, and will use energy-saving measures wherever we can to reduce the carbon footprint of the scheme.

Top of page


Sustainable construction

We're committed to sustainable construction practises and will seek to re-use or recycle construction materials and earthworks on-site where possible, or seek to re-use materials on other highway schemes across the City. By diverting construction waste which would normally head straight to landfill we'll help to reduce costs.

We also aim to utilise green site accommodation, which is better insulated and includes a range of energy saving measures in order to reduce the carbon footprint of the scheme.

We'll utilise the efficient use of natural resources such as solar panels at site compounds during construction, to help tackle the problem of the Earth’s diminishing resources.

Top of page


Local employment and skills opportunities

We aim to support local businesses by using local labour, training and apprenticeship opportunities wherever possible.

Top of page


Note for landowners adjacent to the A1237

Whilst the proposals outlined here illustrate the land required for construction of these works, we're always keen to have discussions with landowners who are willing to offer additional land for tree planting and landscaping.

Top of page


Comments on the YORR proposals

We held an online consultation in November 2020.

Following the consultation we'll carefully consider the responses as we progress the project further and report back to the Executive early in 2021, prior to the submission of a planning application. Any issues raised will be addressed, where possible, in the final scheme design.

Top of page


*This is part of Leeds City Region Enterprise Partnership (LEP) Growth Deal – a £1 billion package of government investment to accelerate growth and create jobs across Leeds City Region.
